Quick Answer
A diesel generator load bank testing procedure includes:
- Pre-test inspection
- Connecting the load bank
- Starting and stabilizing the generator
- Applying load in stages (25% → 50% → 75% → 100%)
- Monitoring key parameters
- Recording performance data
- Gradual unloading and shutdown
In real projects, this procedure is used to verify whether the generator can actually deliver stable output under full load. Without it, performance issues often remain hidden until a real power failure occurs.
What Is a Diesel Generator Load Bank Testing Procedure?
From an engineering perspective, load bank testing is not just about running the generator under load. It is about confirming whether the system behaves correctly under controlled and repeatable conditions.
We have seen many cases where a generator appears to run normally during routine checks, but becomes unstable once real load is applied. In most situations, the issue is not detected early simply because proper load testing was not carried out.
This is why load bank testing is standard practice in:
- Data centers
- Hospitals
- Telecom base stations
- Industrial backup systems
In these environments, an untested generator cannot be considered reliable.
When Should Load Bank Testing Be Performed?
1. Commissioning (Before Handover)
This is the most critical stage. If full-load testing is not performed during commissioning, the system has never been verified under real operating conditions.
In many projects, this is where hidden problems first appear.
2. Periodic Maintenance
Standby generators typically operate at low load or no load. Over time, this leads to:
- Incomplete fuel combustion
- Carbon deposits inside the engine
- Increased risk of wet stacking
Periodic load testing is not only a verification process, but also an effective way to restore proper engine performance.
3. After Repairs or System Changes
After major work such as:
- Engine overhaul
- Alternator replacement
- Control system updates
Load testing is necessary to confirm that the system performs as expected.
Step-by-Step Diesel Generator Load Bank Testing Procedure
The following procedure reflects actual on-site practice.
Step 1: Pre-Test Inspection
Check:
- Fuel quality and level
- Engine oil
- Cooling system condition
- Air intake and exhaust
- Electrical connections
In practice, many test interruptions are caused by basic issues that were not checked beforehand.
Step 2: Connect the Load Bank
- Verify voltage and frequency compatibility
- Use correctly rated cables
- Ensure secure connections
- Confirm proper grounding
For larger generators, improper connection is one of the most common sources of testing problems.
Step 3: Start and Stabilize
- Start the generator without load
- Allow it to warm up for 5–10 minutes
- Confirm stable voltage and frequency
Skipping stabilization often leads to inaccurate test results.
Step 4: Apply Load Gradually
Typical sequence used in most projects:
- 25% load → 10–15 minutes
- 50% load → 15–30 minutes
- 75% load → 30 minutes
- 100% load → 1–2 hours
From experience, applying load too quickly often masks underlying issues rather than revealing them.
In larger systems, load step control and monitoring accuracy can significantly affect the reliability of the test results.
Step 5: Monitor Key Parameters

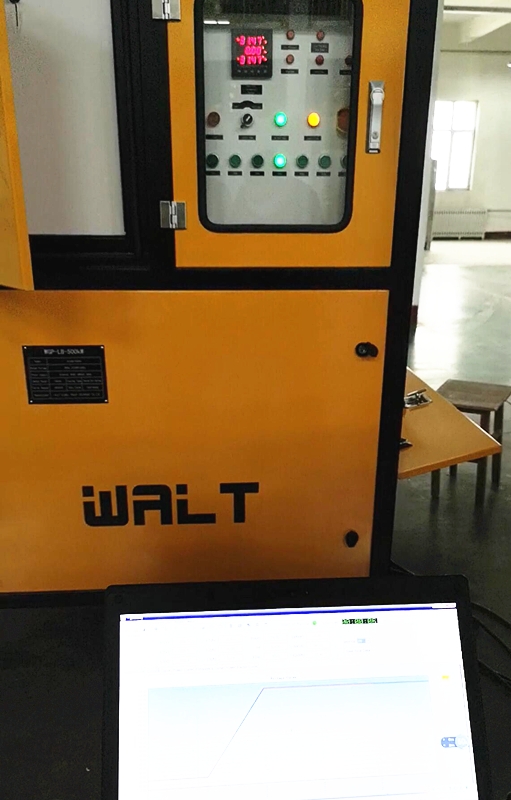

Real-time monitoring of voltage, frequency, and load during diesel generator load bank testing
During testing, focus on:
- Voltage
- Frequency
- Temperature
- Oil pressure
- Exhaust condition
One practical observation:
If black smoke appears at higher load levels, it is usually a sign of incomplete combustion or prior low-load operation.
Step 6: Record Data
Record:
- Load levels
- Duration
- Electrical readings
- Engine performance
- Any alarms
In many projects, these records are required not only for internal reference, but also for client acceptance and compliance documentation.
Step 7: Unload and Shutdown Properly
- Reduce load step-by-step
- Allow the generator to cool under light load
- Shut down properly
Immediate shutdown after full load is not recommended.
What Happens If Load Bank Testing Is Not Done Properly?
In many cases, generator problems are not caused by the equipment itself, but by incomplete or incorrect testing.
Typical consequences include:
- Generator failure during actual power outages
- Voltage instability affecting connected equipment
- Long-term carbon buildup
- Increased maintenance costs
In critical applications, these issues often only become visible during real operation, when the system is already under pressure.
When a Load Bank Becomes Necessary (Practical Judgment)
In theory, generators can be tested using building loads. In practice, this approach has clear limitations.
- Load is unstable
- Load is difficult to control
- Load is often insufficient
From field experience:
- Below ~100kW: limited alternatives may work
- Around 200–300kW: controlled testing becomes necessary
- Above this range: load bank testing is typically required
In some projects, especially where full-load testing must be completed within limited time or space, relying on on-site load is simply not practical.
This is why temporary load bank deployment is commonly used during commissioning and acceptance testing.
Selecting the Right Load Bank (Where Many Projects Go Wrong)
Even when the procedure is correct, using an unsuitable load bank can make the test ineffective.
Capacity
The load bank must be able to reach the generator’s rated capacity.
If it cannot:
- Full-load testing cannot be completed
- Results are not reliable
Voltage Matching
The load bank must match system voltage and frequency.
Mismatch can lead to:
- Connection issues
- Inaccurate results
Load Type
- Resistive: standard generator testing
- Reactive: required for simulating real loads (motors, UPS)
Control and Monitoring
- Manual control: suitable for simple testing
- Automatic control: required for commissioning and large projects
In practice, load bank selection is not always straightforward, especially for larger systems or mixed load applications. Incorrect sizing or configuration can lead to incomplete testing or misleading results.
For this reason, load bank selection is often confirmed together with the testing plan, rather than treated as a separate step.
In projects where multiple generators or phased load testing is required, it is also common to review the overall testing approach in advance to avoid repeated setup or inconsistent results.
Why Load Bank Testing Helps Prevent Wet Stacking
Wet stacking occurs when generators operate at low load for extended periods.
This results in:
- Low combustion temperature
- Incomplete fuel burn
- Carbon deposits
Applying sufficient load:
- Raises combustion temperature
- Improves fuel efficiency
- Removes deposits
This is why load bank testing is also used as a maintenance method.
Recommended Load Levels
Based on practical experience:
- Minimum: ~30%
- Typical range: 50%–80%
- Full load: required during commissioning
Operating below these levels for extended periods leads to performance degradation.
A Practical Observation from Field Work
In one project, a standby generator passed all routine checks.
However, during load testing:
- Instability appeared at higher load
- Exhaust condition changed
- Fuel consumption increased
The issue was related to long-term low-load operation.
Without load bank testing, this would not have been detected before actual use.
Final Engineering Insight
In many projects, the procedure itself is not the main challenge.
The real difficulty lies in:
- Setting correct testing conditions
- Selecting suitable equipment
- Ensuring results reflect real performance
For larger systems or critical applications, this often requires coordination between generator configuration, load bank capacity, and testing sequence.
Conclusion
A diesel generator load bank testing procedure is essential for verifying real-world performance.
From an engineering standpoint:
- The steps are straightforward
- The execution determines the result
In many projects, the difference between a reliable system and a failed one is not the generator itself, but whether proper load testing was carried out under the right conditions.
If you are planning a load bank test for your project, it is often worth confirming the testing setup and load bank sizing in advance to avoid incomplete results or repeated testing.
